A visualisation of the new Hooker Valley #2 Swing Bridge on Aoraki Mount Cook.

Hooker Valley #2 Hybrid Swing Bridge

Are you considering a swing bridge project? We are the experts – talk to DC Structures Studio today!

Visitor information

Overview

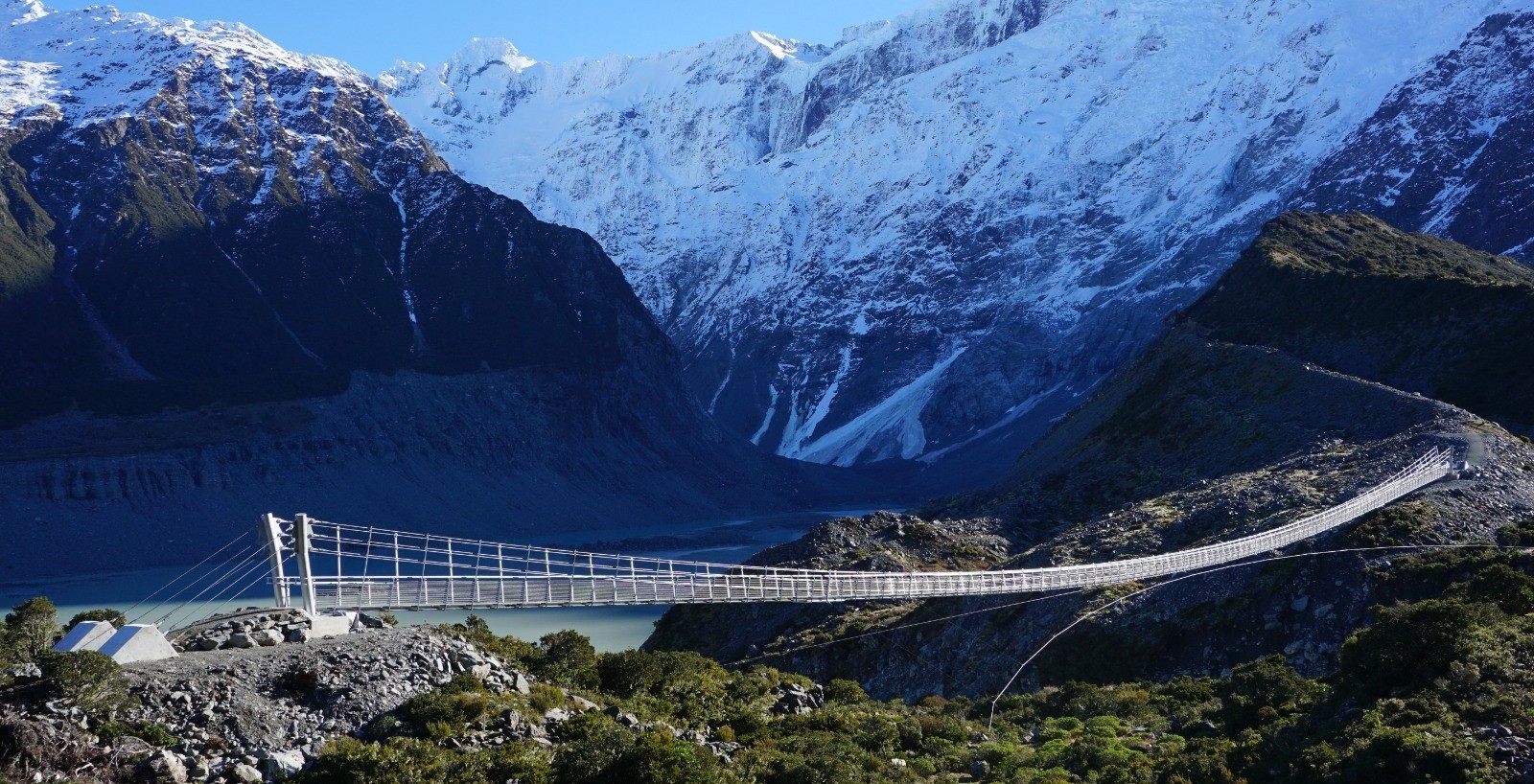

The Hooker Valley Track is the main access track from Mt Cook Village to Hooker Lake, a glacial lake with stunning views of Aoraki Mount Cook, the tallest mountain in Aotearoa New Zealand.

The track crosses three bridges, and bridge #2 is due for replacement. The Department of Conservation (DoC) closed the existing bridge permanently in April 2025. Luckily, work is well under way on the replacement bridge, designed by DC Structures Studio.

At 189 metres, this will be the longest pedestrian bridge in Aotearoa. Mt Cook is a massive tourist destination, and over a million people will cross the bridge each year.

It’s also one of the most stunning locations in the country to be working, and we feel very privileged to design this bridge.

The design is a hybrid model. The main central section is a swing bridge, but there are suspension bridge sections and masts at each end. This lets us lift and stabilise the ends – a 189-metre pure swing bridge would dip a lot in the middle and be very steep at the ends!

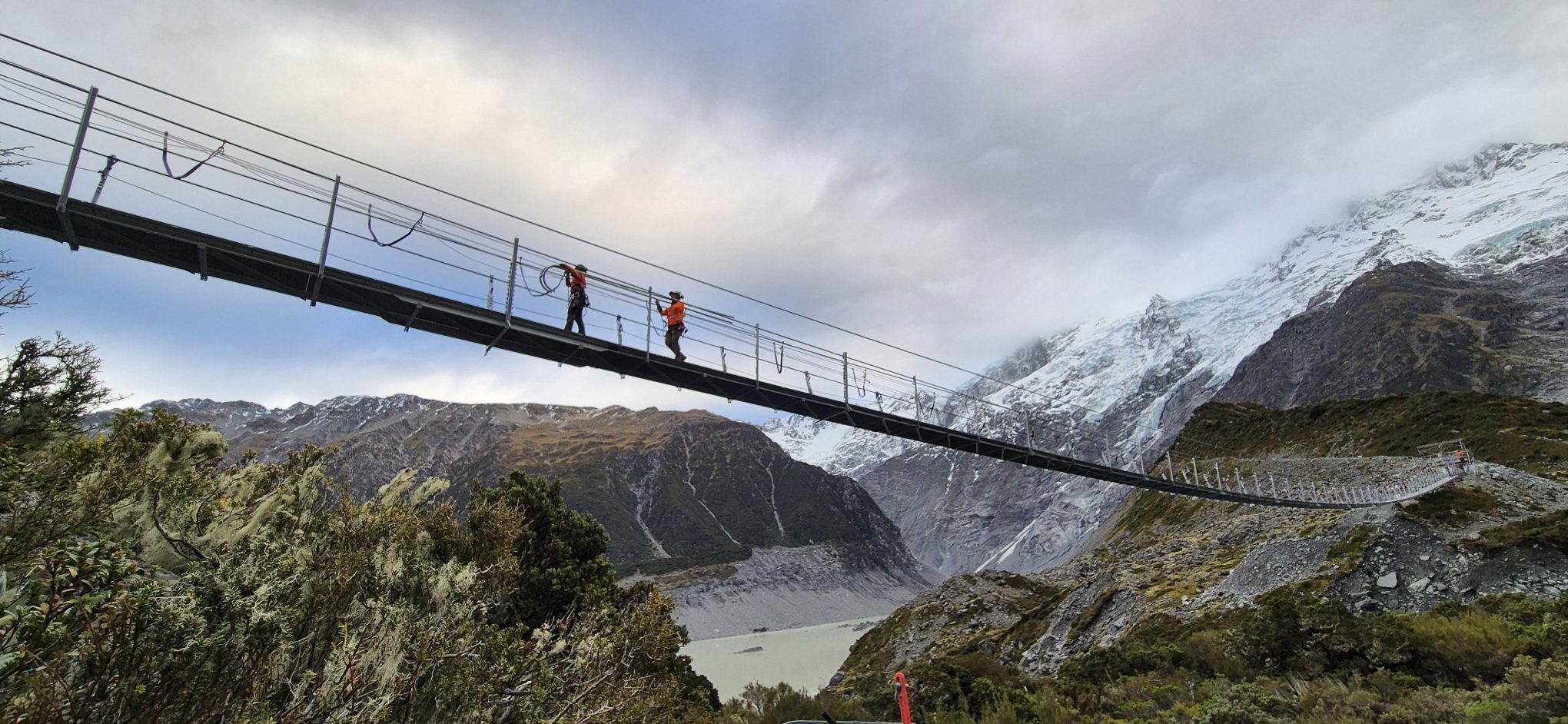

Note: Please do not attempt to visit the work site. The Hooker Valley Track is currently open to a viewing platform overlooking Mueller Lake, past the first suspension bridge, while the upper part of the track is closed due to the construction. DOC has installed security cameras and warned people to stay away from the building site.

A visualisation of the new Hooker Valley #2 Swing Bridge on Aoraki Mount Cook.

Accessing the Hooker Valley Track

Just before you enter Mt Cook Village, turn right into Hooker Valley Road. The track is very well signposted and there is a large carpark and public toilet at the start.

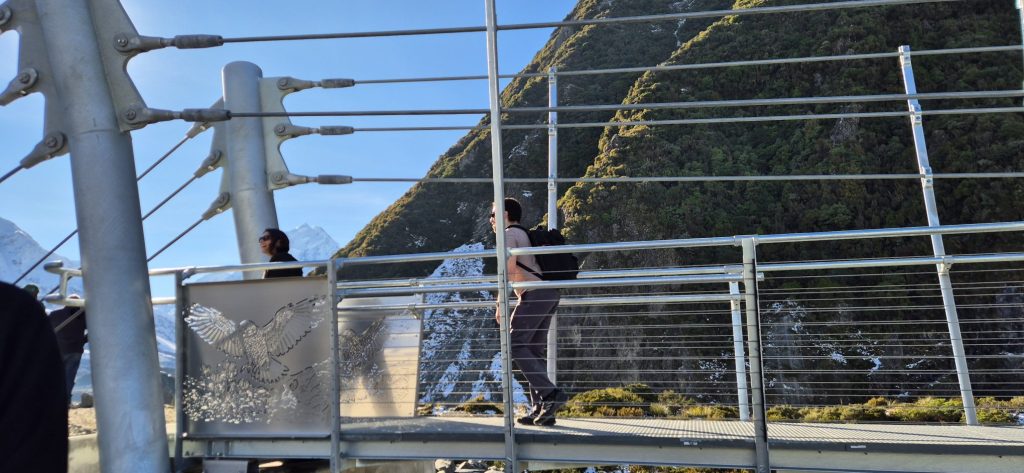

Bridge #2 is currently under construction, and you cannot get all the way to Hooker Lake. However you can still walk the one-hour return trip past Bridge #1 and get great views over Mueller Lake.

Hooker Valley Bridge #2 visitor FAQ

Frequently asked questions.

Technical information

Hooker Valley Pedestrian Bridge #2 is a 189-metre-long swing bridge near Mt Cook Village in the South Island of New Zealand. It is 1.2 m wide and crosses the Hooker River connecting Hooker Lake to Mueller Lake. This is a replacement for the previous swing bridge which closed in 2025.

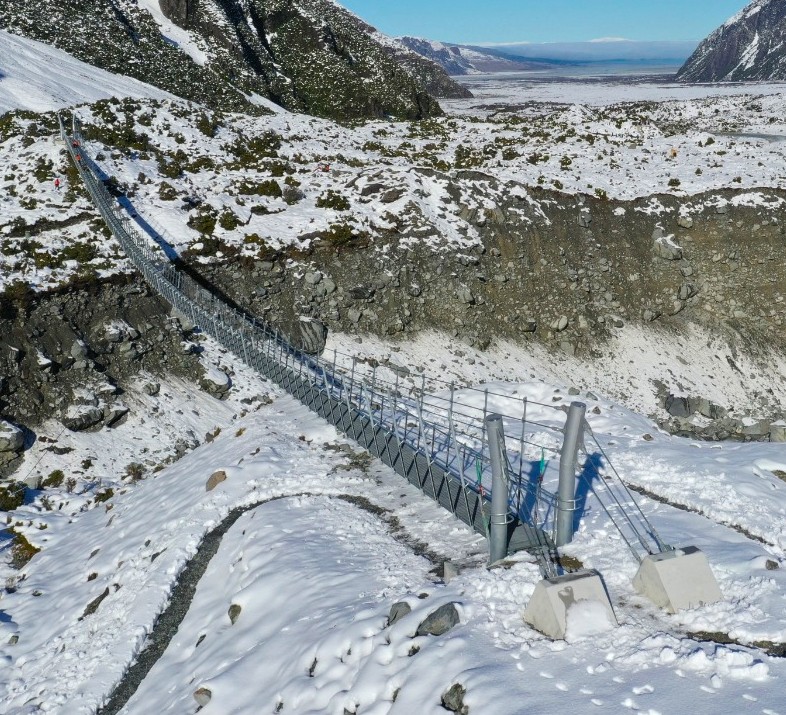

Design of the suspension bridge was completed by DC Structures Studio for the Department of Conservation (DOC) in early 2025. Construction is underway, and is due for completion in 2026.

A swing bridge is appropriate for such a long span, and minimises the visual impact to the landscape. It is also suitable for construction in remote back country.

Towards the end of the bridge we have optimised for a “hybrid” type approach whereby
hangers and cable extend upward past the deck. This has been adopted to enable maximum
gradients of 8% which would otherwise not be possible by a pure swing bridge where end gradients would be excessive.

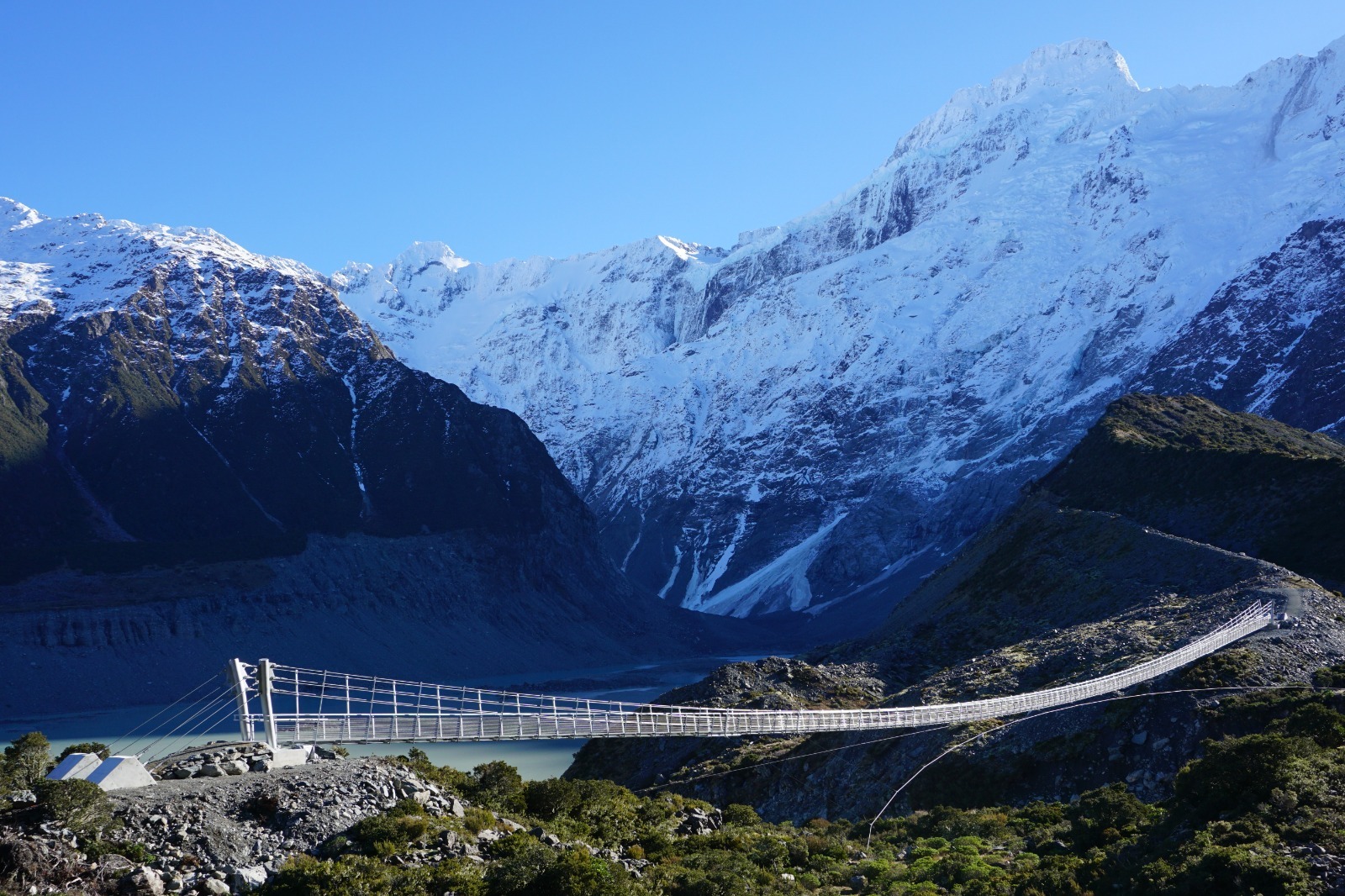

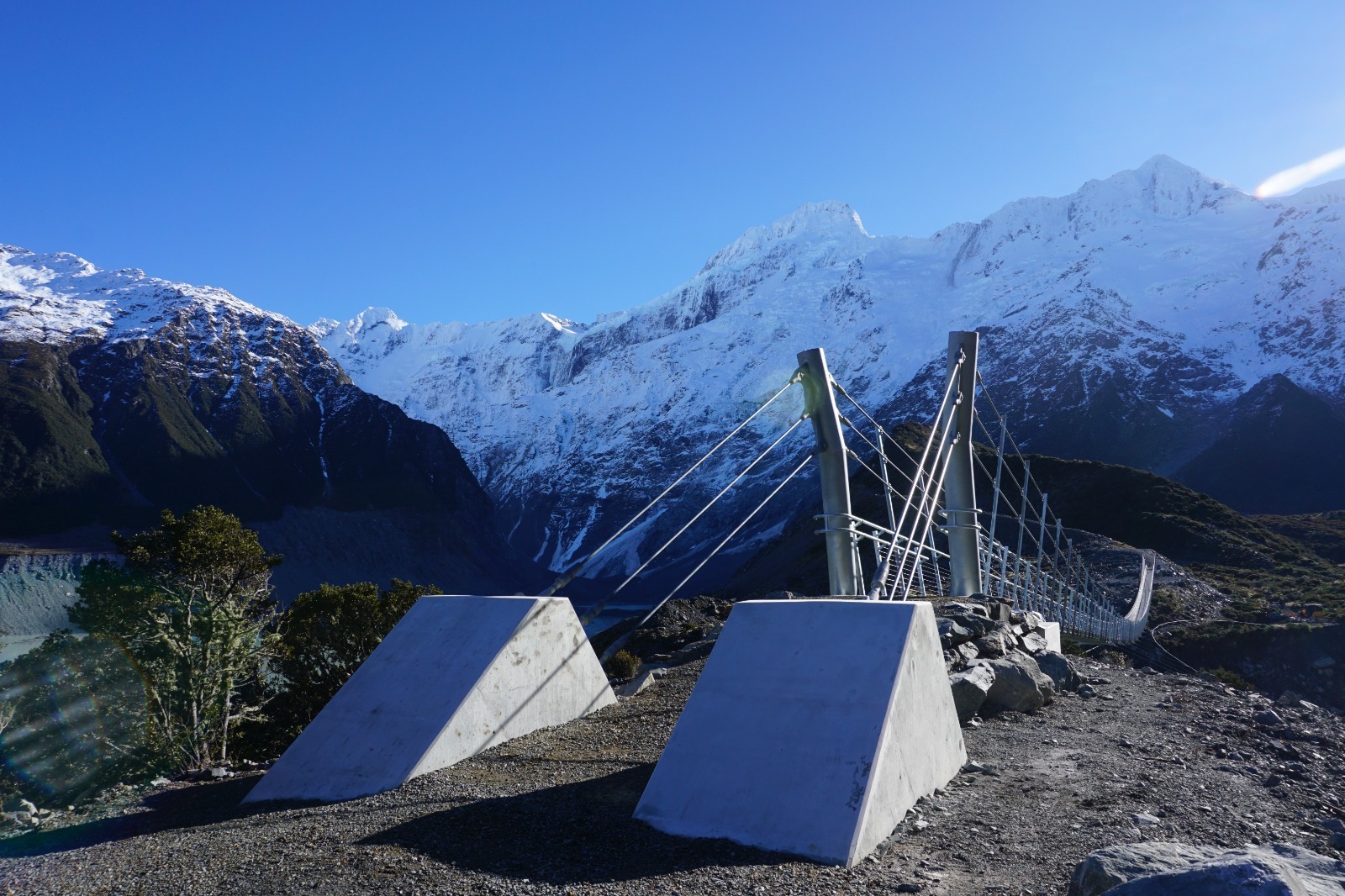

A render of Hooker Valley Pedestrian Bridge #2, showing the on-ramp and suspension lines attached to the rocky surroundings.

There is a 5 m high steel mast at the east and west ends of the Hooker River respectively. The masts are supported on reinforced concrete pads cast directly onto exposed naturally forming and elevated moraine embankments.

The bridge deck is fixed in position at the eastern bank-seat and free to slide longitudinally at the western mast.

The superstructure consists of two parallel flange channel (PFC) stringers spanning onto equal angle (EA) cross beams positioned at 1500 mm horizontal increments along the span.

Parabolic wind cables connected to cross beams via transverse wind-stays restrain the
superstructure in the lateral direction. They also have a vertical component to help stiffen the
overall superstructure.

The walking surface is an anti-slip fibre reinforced polymer (FRP) decking.

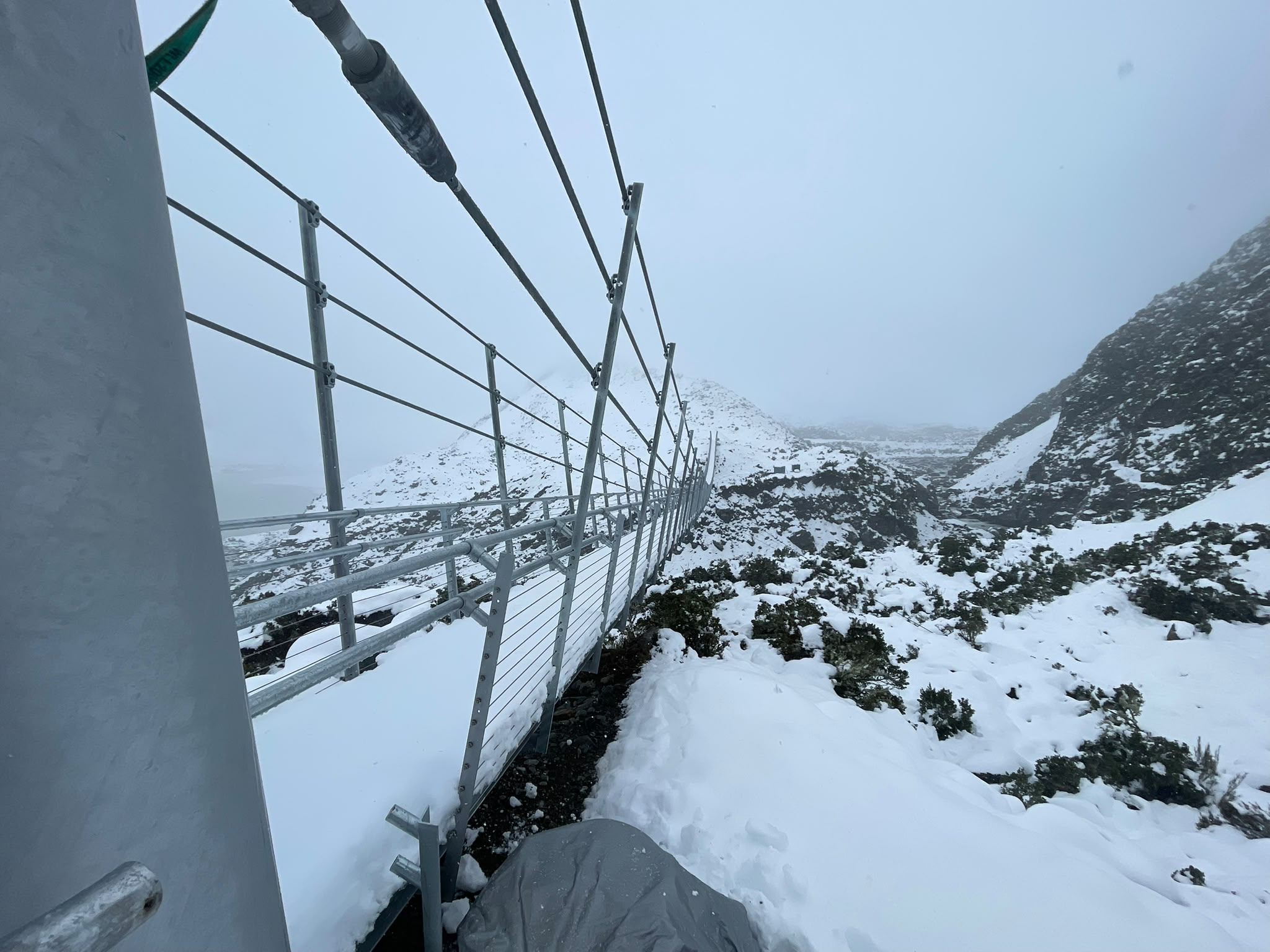

The balustrade will feature two galvanized tubular rails, one acting as a handrail at 1m and the other as a restraint rail at 1.2m. The rails run between hangers and balustrade posts and project inward from stantions.

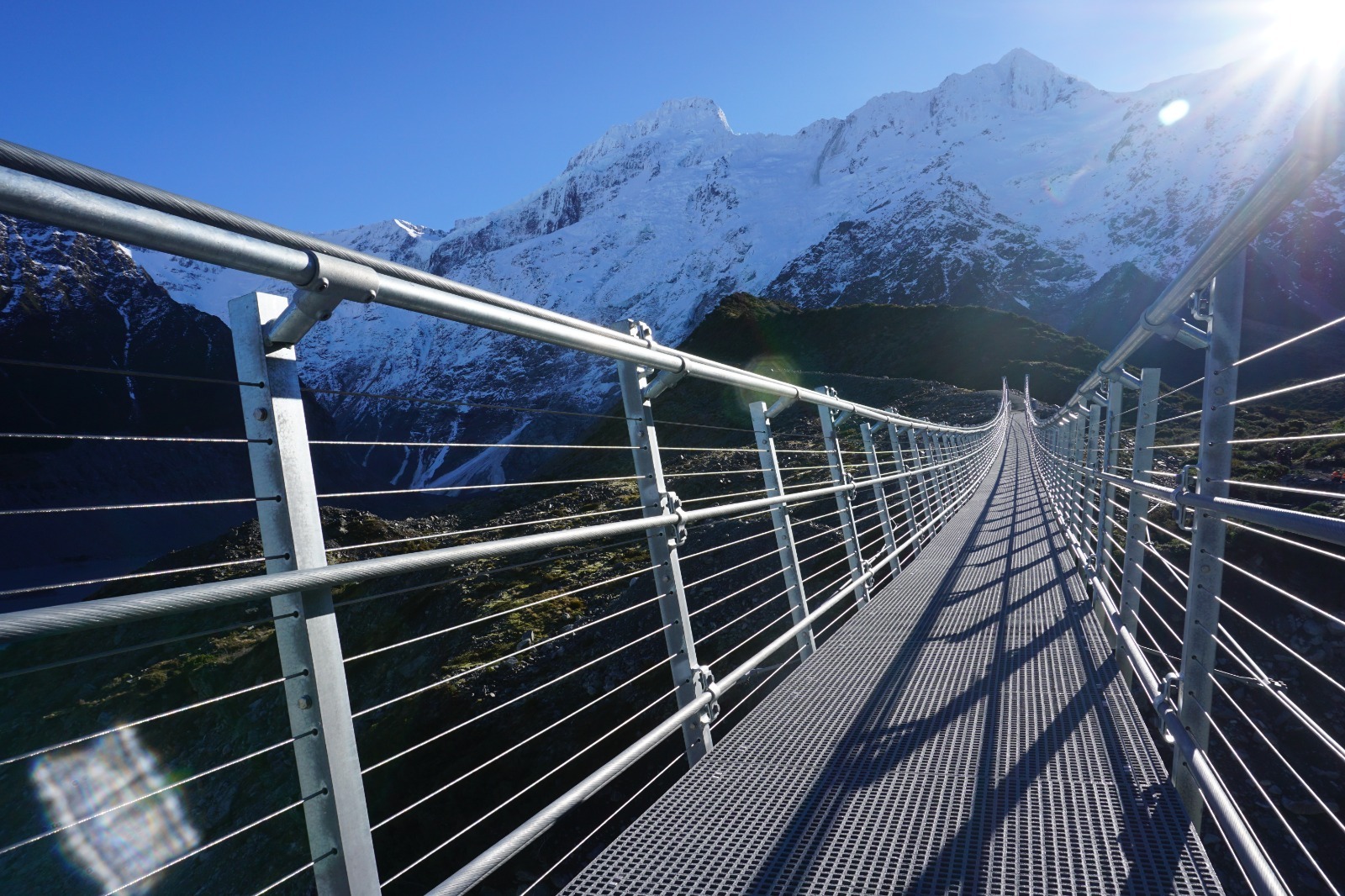

Hooker Valley Bridge #2 cross section showing the walking deck and handrails.
Hooker Valley Bridge #2 long section showing the west mast, concrete anchor and connecting steel cables and joints.

“This hybrid design is a first of its kind. I think it’s a great solution for the location. It’s cost-effective, it’s low-impact on the environment, and we’ve solved the problems associated with really long swing bridges. Not many pedestrian bridges are this long, but we hope to see our concept become a baseline for this type of bridge around the world.”

[Dan Crocker – Chief Bridge Architect & Engineer]

Quick notes

  • On completion will be the longest span footbridge in New Zealand.
  • Global structural analysis using state-of-the-art SAP2000 software for NZ’s longest
    spanning footbridge.
  • Use of “hybrid” bridge form (½ swing bridge + ½ suspension bridge) to optimise user gradients and minimise mast height for maintenance purposes.
  • Complex localised finite element shell model of mast and backstay assemblies.
  • Designed to NZTA Bridge Manual 3rd Edition for 100-year design life with live loads varying with loaded length.
  • Considers “cable loss” scenarios to international design codes.
  • Onsite anchor testing prior to confirming design to minimise client commercial risk.
  • Assessment and allowance for ongoing scour effects through this highly dynamic glacier mountain range.
  • Detailed aeroelastic wind analyses to understand dynamic behaviour in varying wind velocities. Included comprehensive computation fluid dynamics (CFD) which is a computer driven wind tunnel assessment method.
  • Included time history assessment for pedestrian footfall dynamics to latest international codes with detailed consideration of the effects, outcomes, and recommendations for the benefit of our client.
  • Using the hybrid system enabled us to minimise the mast height so helicopter erection will be vastly simplified (smaller and lighter with no splicing).

Key partners

We would like to thank the following organisations for their help and support in getting this project off of the ground.

Dept. of Conservation
Client and Design Collaborator
Abseil Access logo
Abseil Access
Construction Contractor
LET'S TALK
about your
next project.
We can help you fall in love with bridges...
CAMBRIDGE OFFICE
26 Alan Livingston Drive
Cambridge
New Zealand 3434
8:30 am to 17:30 pm, Monday to Friday
